Four corners carry everything
Container Foundation Options
The figure above shows the whole story: a container is a bridge between its four corner castings. At sea, whole stacks of loaded containers press down through those same four points; nothing in the design expects support under the middle. Mid-span bearing does nothing structurally — a container resting on a perfectly flat slab still carries itself corner to corner.
That inverts the usual building instinct. You do not need a foundation under the container; you need four hard, level points under its corners — and getting those four points in one plane matters more than what they are made of.
The four standard options

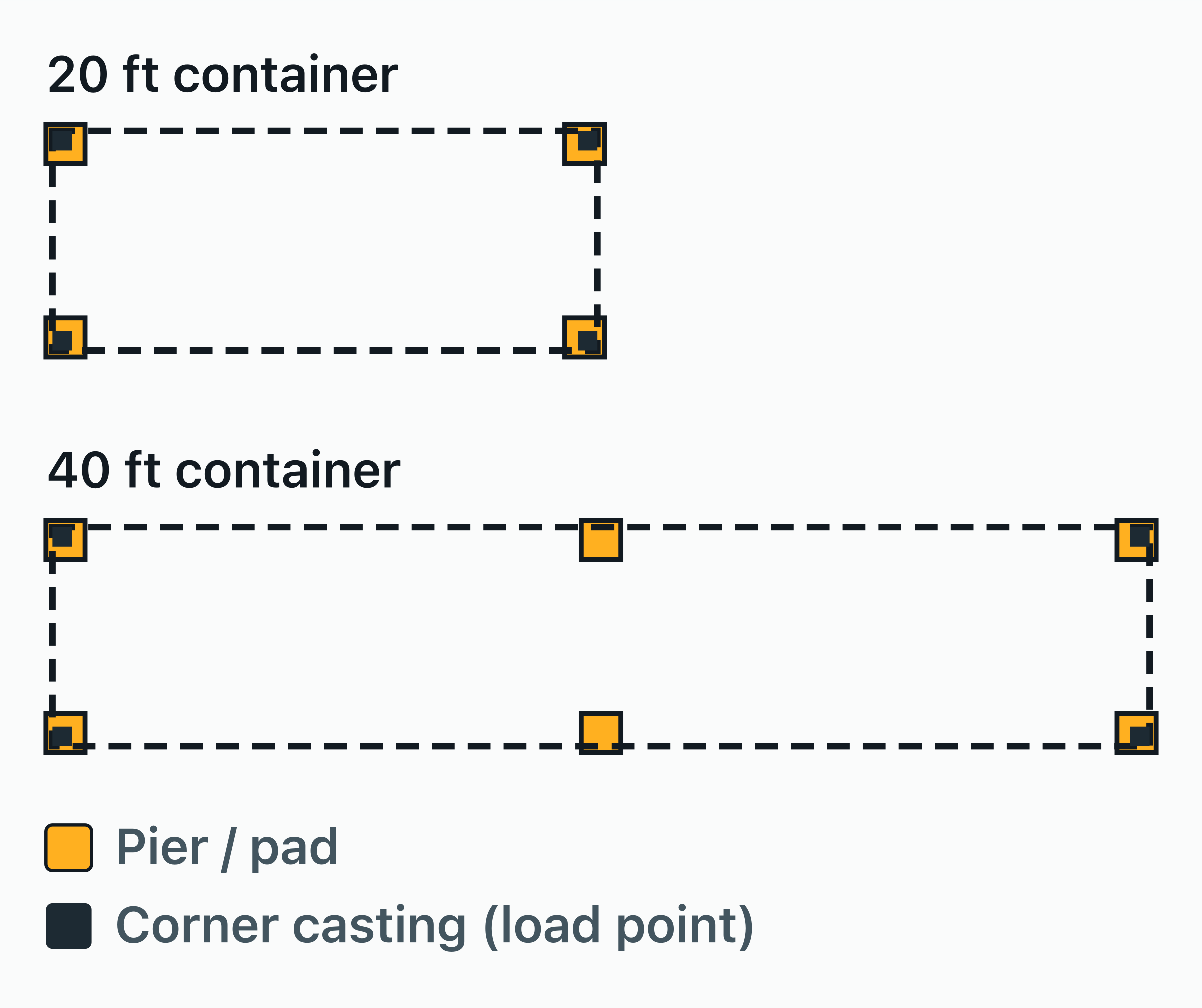

Concrete piers — the most common: four piers of roughly 400 × 400 mm, dug below the local frost line, one under each casting. Cheap, permanent, and they lift the box off damp ground so air circulates beneath.
Concrete slab — structurally optional; chosen for a clean working surface, vehicle access or because a slab already exists. The container still bears only at its corners.
Gravel pad with sleepers — compacted gravel with railway sleepers or paving slabs under the corners: the temporary-siting standard, fully reversible, fine for storage.
Screw piles — steel helical piles wound into the ground, no excavation or curing: fast, precise to level, and the usual answer on sloping or poor-draining sites.
Level is the specification
The container tolerates a surprising amount of abuse but not twist: if one corner sits roughly 10 mm or more out of the plane of the other three, the door frame racks and the doors bind or gape. This is the single most common siting fault — a container whose doors closed perfectly at the depot and jam on site is sitting on a twisted base, not broken. Check with a spirit level across both end frames and shim under the low casting with steel plate; the doors free up as the frame squares.
Does a 40 ft need support in the middle?
Structurally, no — the underframe is designed to span the full 12 m corner to corner, loaded. What mid-span piers buy on a 40 ft unit is comfort, not strength: under foot traffic and workshop machines the long floor has perceptible bounce, and a pier under the cross-members stops it. Fit them for a workshop conversion if the flex annoys you; never let them replace properly supported corners, and never shim the middle higher than the corner plane — that twists the frame in the opposite direction.
Permits before piers
A container on temporary sleepers is one conversation with the local authority; a container on permanent foundations is usually another — in many jurisdictions, fixing the box to piers or a slab is precisely what reclassifies it from temporary placement to a permanent structure requiring a permit. If the container will be occupied, the full planning picture is covered in container home dimensions.
Frequently asked questions
Does a shipping container need a foundation?
It needs four firm, level bearing points under its corner castings — not necessarily a foundation in the conventional sense. Compacted gravel with sleepers suffices for temporary storage; concrete piers below the frost line are the permanent standard. A full slab is optional.
How many piers does a 40 ft container need?
Four — one under each corner casting — carry the full structural load. Add mid-span piers under the cross-members only to damp floor bounce in workshop or living use; they are comfort, not structure.
Can you put a shipping container on gravel?
Yes — a compacted gravel pad with sleepers or slabs under the corner castings is the standard temporary siting. It drains well and keeps the underframe off wet ground; just get the four bearing points level to within about 10 mm.
Why do container doors jam after siting?
Twist: one corner sitting out of the plane of the other three racks the door frame. It is a base problem, not a door problem — shim under the low corner casting with steel plate until all four are level, and the doors close again.
